VANCOUVER, BC / ACCESSWIRE / June 26, 2023 / Guanajuato Silver Company Ltd. (the "Company" or "GSilver") (TSXV:GSVR)(AQUIS:GSVR)(OTCQX:GSVRF) announces that as part of a scheduled program to update GSilver's NI 43-101 technical reports and resource estimates for all of its producing mines in Mexico, the Company is presenting positive results from its new "preliminary economic assessment" of GSilver's 100% owned El Cubo Mines Complex located in Guanajuato, Mexico titled "Preliminary Economic Analysis - El Cubo/El Pinguico Silver Gold Complex Project, State of Guanajuato, Mexico" (the "2023 PEA"). The 2023 PEA, was prepared by Behre Dolbear & Company (USA), Inc. ("Behre Dolbear") in accordance with National Instrument 43-101 ("NI 43-101"), is dated June 23, 2023, with an effective date of December 31, 2022, and is available for review on SEDAR and at the Company's website at https://www.gsilver.com. All dollar amounts are expressed in USD.

James Anderson, Chairman and CEO, said, "Guanajuato Silver has grown significantly over the past two years through a strategy of acquiring older mines in the Guanajuato Mining Camp and the State of Durango, and bringing them efficiently back into production. Because of the nature and swiftness of these acquisitions, most of the mineralized material at these mines were categorized as historical resource estimates. As previously announced, we have initiated a program to upgrade our existing resources and historical estimates to current resources (see Guanajuato Silver news release dated February 23, 2023 -"Guanajuato Silver Drills 6,981 g/t AgEq at San Ignacio and Prepares to Expand Production"); appropriately, the El Cubo Mines Complex is the first to be updated. We anticipate a current resource estimate for our San Ignacio mine to be completed later this year. The 2023 PEA replaces Behre Dolbear's previous preliminary economic assessment report issued on May 6, 2021, with an effective date of January 31, 2021."

Mineral Resource Estimate

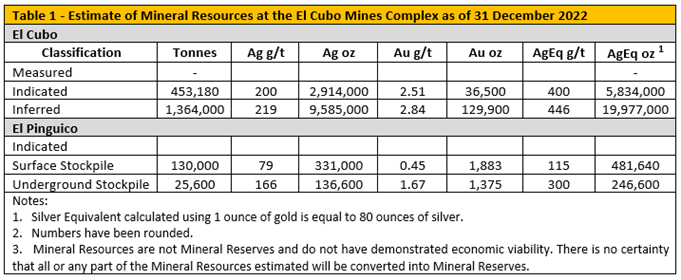

The upgraded mineral resource for the El Cubo Mines Complex as extracted from the 2023 PEA is presented in Table 1 below:

Guanajuato Silver Company Ltd., Monday, June 26, 2023, Press release picture

1 The silver equivalent ("AgEq") ounces shown in this column are not included in the 2023 PEA and have been estimated and added directly by GSilver for ease of reference and comparison purposes based on a ratio of 1 ounce of gold is equal to 80 ounces of silver, (one troy ounce converted to the metric system equals 31.1035 grams).

Mr. Anderson added, "This updated PEA envisions a six-year mine life; however, El Cubo has already demonstrated a production history that has extended well over 100-years. Our goal is to continually increase mineral resources through in-fill and exploration drilling to end each year with 125% of the total resources that we started the year with; if we can achieve this, we believe that El Cubo can continue to be a significant silver producer for decades to come."

The mineral resource estimate used as the basis for the 2023 PEA was developed by Behre Dolbear using the December 31, 2016 mineral resource estimate and computer models developed for El Cubo by Endeavour Silver Corp. ("Endeavour"), El Cubo's previous owner, and GSilver's February 28, 2017 resource estimate for the El Pinguico property.2,3 Behre Dolbear has extensively reviewed and audited the primary drilling data, computer models, wireframes, estimation methods, and the previous estimates and the El Cubo mill production in 2021 and 2022 to help develop the estimate of the current mineral resources at the El Cubo Mines Complex.

Although Endeavour and GSilver significantly increased the drilling and sampling data at El Cubo beyond the data in the 2016 database which has been used for the El Cubo 2023 PEA mineral resource estimate, such drilling was primarily exploration drilling on parallel vein structures and requires additional infill drilling to achieve a drill spacing adequate for an inferred mineral resource estimate. Accordingly, the results from such subsequent drilling by Endeavour and GSilver have not been used in the calculation of the mineral resource estimate for El Cubo as of December 31, 2022 in the 2023 PEA. The 2023 PEA includes a recommendation that targeted drilling should be completed to increase the mineral resource tonnage, classification, and mine life prior to a pre-feasibility study (see Section 14.0 Mineral Resource Estimate and Section 26.0 Recommendations in the 2023 PEA).4

The remaining mineral resources at El Cubo, as of December 31, 2022, total approximately 0.45 million tonnes of indicated resources and 1.36 million tonnes of inferred resources. There is no certainty that all or any part of the mineral resources estimated will be converted into mineral reserves. Mineral reserves have not been identified for El Cubo or El Pinguico.

Preliminary Economic Assessment

Behre Dolbear also prepared a discounted cash flow model for the El Cubo Mines Complex excluding El Pinguico ("El Cubo")5, to determine the Net Present Value (NPV), Internal Rate of Return (IRR), and payback period.

Key parameters integral to Behre Dolbear's preparation of the cash flow model and determination of NPV include:

  • All results are expressed in US Dollars (US$).
  • The analysis is based on a 100% equity basis. Specific business considerations, such as debt or equity financing and detailed tax strategies, have purposely not been included or analyzed in detail.
  • All cash flows are determined on an after-tax basis.
  • Net Present Values (NPV) are determined, assuming end-of-year cash flows.
  • All costs and revenues reflect "real" or constant 2023 dollars without escalation.
  • The measures used in the PEA are metric except where, by convention, gold and silver content, production, and sales are stated in troy ounces.

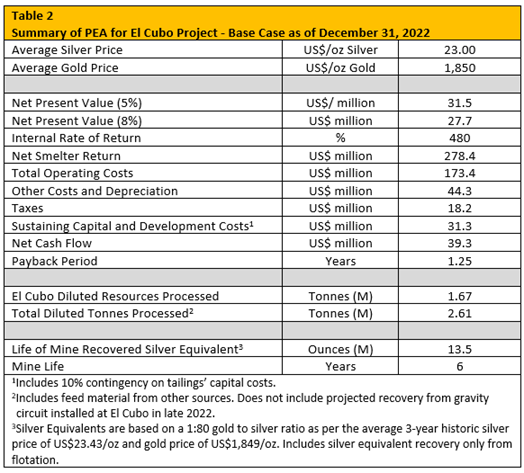

A summary of the updated preliminary economic assessment for El Cubo as at December 31, 2022 as extracted from the 2023 PEA is set out in Table 2 below.6

Guanajuato Silver Company Ltd., Monday, June 26, 2023, Press release picture

The following is a summary of certain cash flow model inputs reflected in the 2023 PEA. Readers should refer to the 2023 PEA directly for a complete discussion of these and other inputs.

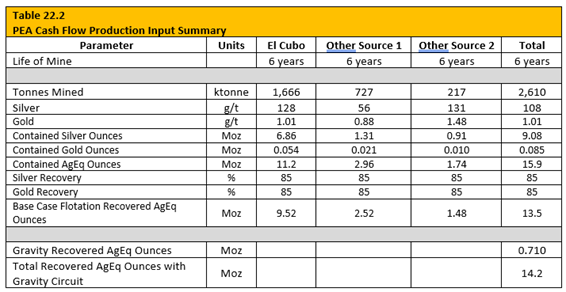

● Life of Mine and Production Forecasts. The cash flow model incorporates a 6-year operating and development period prepared on the basis of the diluted tonnages summarized in Table 22.2 below. At steady state, the average monthly targeted production rate is 36,250 tonnes per month for an average annual total of 435,000 tonnes per year mined and processed. The overall projected base case production is summarized in Table 22.2. Also shown in Table 22.2 is the projected silver equivalent recovery with the addition of the gravity circuit at El Cubo at the end of 2022.

Guanajuato Silver Company Ltd., Monday, June 26, 2023, Press release picture

● Commodity Prices and Net Smelter Return. The use of historical metal prices is a generally accepted methodology for modeling long-term commodity prices. For the 2023 PEA, Behre Dolbear used base case silver and gold prices of US$23.00/oz of silver and US$1,850/oz of gold on the basis of the 3-year rolling average of prices of US$23.43/oz silver and US$1,849/oz gold.

The net smelter return (NSR) was determined on the basis of, inter alia, revenues of 97.5% of payable silver and gold content, less a treatment charge of US$350 per dry tonne DAP, a refining charge of US$1.00 per ounce of payable silver and US$8.00 per ounce of payable gold per dry tonne of concentrate, and freight charges of 30,000 pesos per truck carrying 33 wet tonnes of concentrate containing 12% moisture.

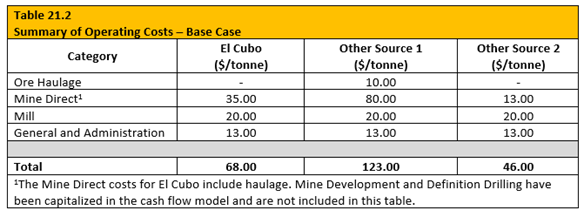

● Operating Costs. Average mining, processing and administration costs for six years of operations based on current experience at El Cubo are presented in Table 21.2 below:

Guanajuato Silver Company Ltd., Monday, June 26, 2023, Press release picture

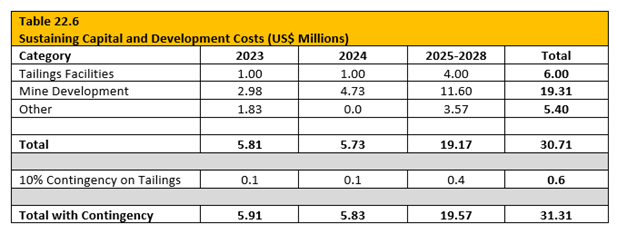

● Development and Capital Costs. The development and capital costs associated with mine development and equipment, new tailings facility, and facility improvements for the remaining mine life at El Cubo are shown in Table 22.6 below. Included in the sustaining capital costs is the construction of additional capacity in the Tailings Storage Facility 3-B. The construction is scheduled to begin in 2023 and will be completed by 2026 at an estimated capital cost of US$6.0 million. The tailings facility includes a tailings filtration plant. The other sustaining capital costs include general improvements to the mine and mill.

Guanajuato Silver Company Ltd., Monday, June 26, 2023, Press release picture

● Other Costs and Taxes. Other costs include:

Mining Rights Tax....................................................... 7.5% of EBITDA
Government Fee on Precious Metals........................... 0.5% of silver gross revenues
Workers Profit Share................................................ 10% of pre-tax profits

These costs are based on the requirements of the Mexican government. Depreciation was determined on a straight-line basis for 8 years as per Mexican tax laws. The income tax rate is projected at 30% of operating profit (sales income or revenue less royalties, operating and other costs, and depreciation).

● Sensitivity Analysis

To determine the effect of changes in several of the base case assumptions, a sensitivity analysis was prepared for each operating scenario. Certain factors, such as commodity prices, operating costs, and capital costs, could have a significant effect on the financial performance of El Cubo. The objective of the sensitivity analyses is to determine the effect of several varying key parameters, as a point of comparison to the base line results. The following parameters were evaluated.

  • Discount rates ranging from 0% to 10% were applied to determine the effect on NPV.
  • Commodity prices generally have the greatest effect on mining project economics. The sensitivity to changes in commodity prices was determined on the basis of a constant gold-to-silver price ratio of 1:80, which is consistent with historical data.
  • The cash variable operating costs were varied to determine the effect on NPV.
  • Both the initial and sustaining capital costs were varied.

In each case, the particular parameter was changed for each year during the life of the mine (LOM) review. In reality, it is unlikely that each of the varied parameters would experience the same increases or decreases over the entire LOM. As such, these sensitivity analyses present the best or the worst-case scenarios in the ranges evaluated. The purpose of the sensitivity analysis is to provide an indication of the relative effect that a specific operating parameter can have on the overall project economics.

Of the sensitivity factors reviewed, the discounted cash flow was significantly affected by variations in both the commodity prices and operating costs.

At the 3-year historical average silver price of US$23.00/oz and a gold price of US$1,850/oz, the 5% NPV is US$31.5 million. At a 20% decrease in silver equivalent price, El Cubo continues to demonstrate a positive NPV(5), NPV(8), and an IRR of 85%.

Based on the results of the sensitivity analysis, the average NPV(5) breakeven price is approximately US$18.00/oz of silver and US$1,440/oz of gold (assuming a constant gold-to-silver ratio of 1:80). There is minimal difference in the breakeven price at a 5% or 8% discount rate.

● Feed Material from Other Sources

The base case cash flow model includes feed material from other sources as per GSilver's plan of operation including GSilver's San Ignacio mine and VMC in Guanajuato, Mexico. If the additional material is not fed to the El Cubo mill, the base case NPV(5) is reduced by 32% from US$31.5 million to US$21.3 million. If the projected recovery from the gravity circuit is included, the base case NPV(5) is only reduced by 9%. Behre Dolbear notes that it is unlikely that additional feed to the El Cubo mill will not be available as there are remaining mineral resources at El Pinguico as well as potential additional material from San Ignacio and VMC. The mineral resources at El Pinguico have not been included in the base case cash flow model.

● Footnotes

2 National 43-101 Technical Report: Updated Mineral Resource and Reserve Estimates for the El Cubo Project, Guanajuato State, Mexico for Endeavour Silver by Hard Rock Consulting, LLC. Effective Date, December 31, 2016, Report Date: March 3, 2017. Downloaded from SEDAR.

3 NI 43-101 Technical Report for the El Pinguico Project, Guanajuato Mining District Mexico for VanGold Mining, authored by Carlos Cham Dominguez of FINDORE S.A. DE C.V., effective date February 28, 2017. Downloaded from SEDAR.

4 See the 2023 PEA for further details of the key assumptions, parameters and methods used to estimate the current mineral resources at El Cubo and El Pinguico.

5 GSilver's current mine plan does not include production from El Pinguico's existing stockpiles as GSilver suspended processing of mineral resources from such stockpiles in July 2022 to focus on processing higher grade material from El Cubo and its subsequently acquired San Ignacio mine and Valenciana Mines Complex ("VMC") in Guanajuato, Mexico.

6 The cash flow model includes indicated and inferred resources for El Cubo and material from other sources not included in the El Cubo mineral resources including mineralized material from GSilver's nearby 100% owned San Ignacio mine and VMC in Guanajuato, Mexico. Also, the current mine plan does not include production from the existing El Pinguico stockpiles as noted in footnote 5 above.

Cautionary Statement:

The above economic analysis is preliminary in nature and includes inferred mineral resources that are considered too speculative to have the economic considerations applied to them that would enable them to be categorized as Mineral Reserves. Mineral resources that are not Mineral Reserves do not have demonstrated economic viability. Further, there has been insufficient exploration to allow for the classification of the inferred mineral resources as an indicated or measured mineral resource; however, it is reasonably expected that the majority of the inferred mineral resources could be upgraded to indicated or measured mineral resources with continued exploration. There is no guarantee that any part of the mineral resources disclosed herein will be converted into a mineral reserve in the future or that the 2023 PEA will be realized.
